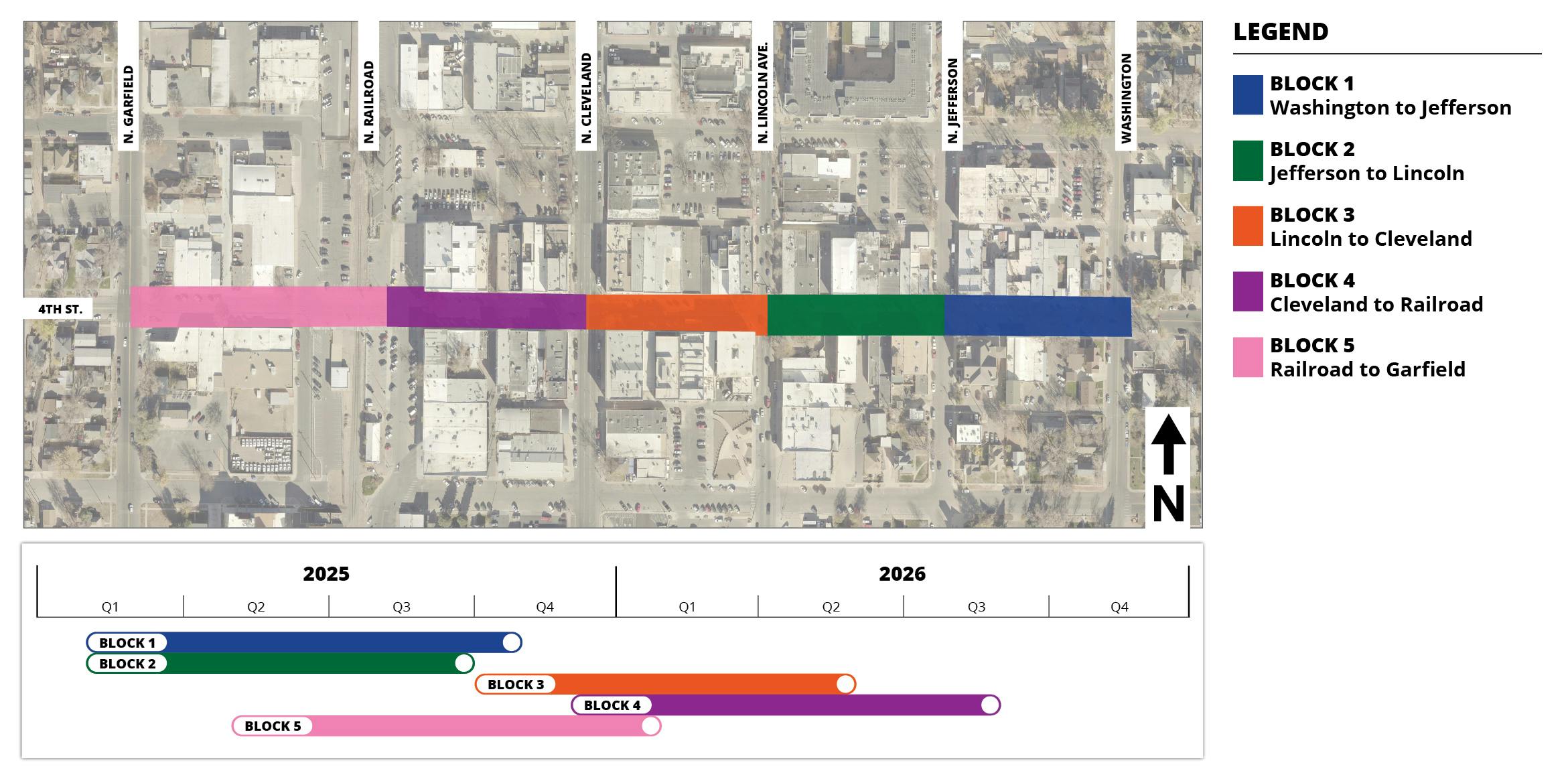

Heart Improvement Plan (HIP Streets)

Share Heart Improvement Plan (HIP Streets) on Facebook Share Heart Improvement Plan (HIP Streets) on Twitter Share Heart Improvement Plan (HIP Streets) on Linkedin Email Heart Improvement Plan (HIP Streets) link

In 2009, the City of Loveland Public Works Department developed the conceptual plan for the Heart Improvement Plan (HIP Streets), which explored opportunities to enhance the streets within the historic core of Downtown Loveland. In 2017, after gathering public input, the plan was modernized to include a thoughtful and cost-effective approach to revitalizing 19 core blocks of Downtown Loveland.

The first phase of the Heart Improvement Plan – the 4th Street Revitalization – addresses the five blocks along 4th Street that extend from Garfield Avenue to Washington Avenue. The current effort is focused on improving 4th Street through streetscape enhancements, while the City of Loveland Water and Power Department works on upgrades to the utility infrastructure beneath the road. As this project is a significant effort, the City of Loveland and the Loveland Downtown Development Authority (DDA) have come together to finally bring this portion of the Heart Improvement Plan to fruition. We’re excited to reimagine our Downtown and it all starts with 4th Street.

Our project team is composed of local industry professionals who understand the importance of these improvements and are committed to making this a project our community can be proud of while embracing our historic core and creating a vibrant space that highlights our artistic community.

Project Vision

Create a functional, aesthetically pleasing, eclectic Downtown environment that facilitates business vitality, fosters a sense of community, and accentuates the identity of the Downtown commercial district.

Incorporate streetscaping as part of an existing major infrastructure project to minimize business impact and improve the built environment.

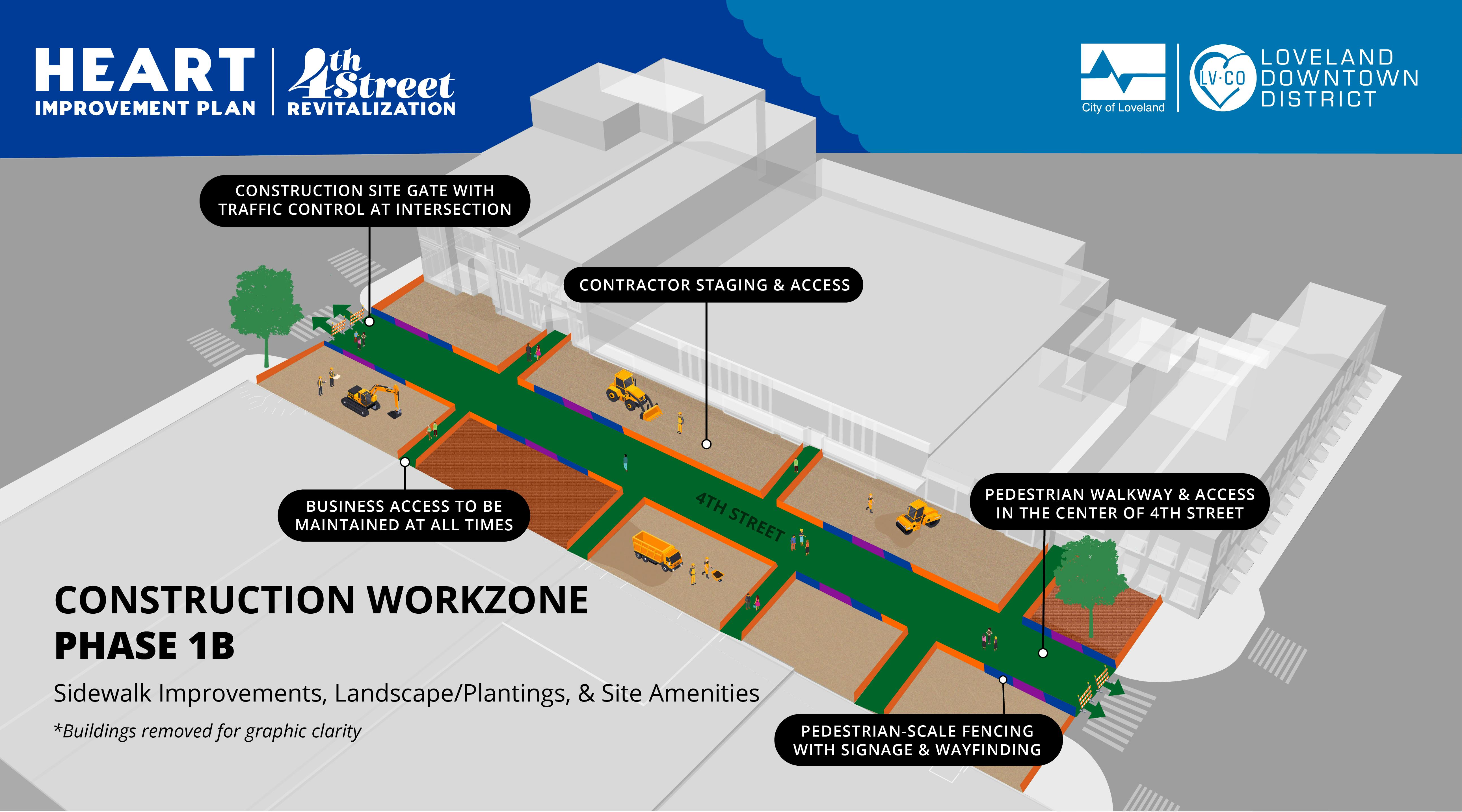

Project Impacts

By late February 2025, the City of Loveland aims to begin construction, starting with underground water and stormwater utility improvements. Once infrastructure improvements are complete, the City of Loveland will focus on surface improvements determined by the streetscape design. Between utility and streetscape improvements, each block is anticipated to take six to eight months to construct.

Pedestrian access to 4th Street businesses will remain open throughout the project, however, the road will be closed to vehicular traffic. Visitors can access the corridor by parking in lots along 5th Street and by using other nearby designated on-street parking. Visit the downtown parking webpage for a map of available parking options.

Updates

  • Adopted Concept Plans (2009)
  • Parking Studies (2018/2019)
  • Revised Modernization Plan (2017)
  • Infrastructure Assessment (2019)
  • 4th Street Construction Design and Drawings (2023)
    • Parking study updated
    • Present updated plans to LRFA, City Planning Commission, Loveland Parks and Recreation, APP, City Management and DDA Board (07/2023-08/2023)
    • First Open House at The Foundry to review public input (08/23/2023)
    • Second Open House at the Desk Chair Workspace to gather additional input (12/12/2023)
    • City Council Update (01/23/2024)

Project Goals

  • Focus on Economic Vitality
    • Attract new downtown visitors and patrons to encourage tourism
    • Minimize construction disruption
    • Finish the project with no business loss or claims
    • Allow for efficient access, parking and circulation
    • Catalyze business potential in under-utilized areas
  • Create a Comfortable and Inviting Downtown Experience Unique to Loveland
    • Create a safe environment that is activated at night and day
    • Develop a vibrant, engaging and unique streetscape as a regional destination
    • Capitalize on artistic spirit and attitude towards placemaking
    • Build upon the unique Downtown Loveland identity
    • Incorporate art and culture in design and user experience
    • Identity and History, unique to Loveland
  • Create a Flexible and Adaptable Streetscape
    • Flexible and functional space for a variety of uses
    • Allow for ease of seasonal programming needs
    • Inviting and appealing place for a broad demographic to stimulate diverse businesses
    • Design and build an easily maintained space
    • Create more safe and comfortable walking/pedestrian zones
  • Foster Partnerships for Long Term Success
    • Provide for sustained stakeholder engagement
    • Ensure Downtown Business support throughout project

Project Funding

On Tuesday, Nov. 19, 2024, Loveland’s City Council unanimously approved using Certificates of Participation (COPs) to help fund the Heart Improvement Plan’s 4th Street Revitalization project. The $24.5 million project will be paid for through a mix of Utility Enterprise Funds and COPs. Utility Enterprise Funds (Stormwater, Water and Power) will contribute $12 million, while the remaining $12.5 million will come from COPs paid by the Downtown Development Authority (DDA). No General Funds will be used for this project.

Stay Informed During Construction

Whether you live outside downtown or are directly affected by the construction, we have project updates tailored to your needs.

  • General Public Updates: Receive updates on essential project news, major milestones, city-wide impacts, and opportunities to get involved in marketing and community events.
  • Downtown Business/Resident Updates: Receive detailed information about construction impacts, traffic changes, neighborhood-specific updates, and how your business can participate in marketing campaigns and support programs.

To sign up for the project newsletter, join the Heart Improvement Plan Email List. To contact the project team, call the Public Works Department at 970-962-2524 or email HIPStreets@cityofloveland.org. Please allow at least 24-48 hours for a response. Thank you!

In 2009, the City of Loveland Public Works Department developed the conceptual plan for the Heart Improvement Plan (HIP Streets), which explored opportunities to enhance the streets within the historic core of Downtown Loveland. In 2017, after gathering public input, the plan was modernized to include a thoughtful and cost-effective approach to revitalizing 19 core blocks of Downtown Loveland.

The first phase of the Heart Improvement Plan – the 4th Street Revitalization – addresses the five blocks along 4th Street that extend from Garfield Avenue to Washington Avenue. The current effort is focused on improving 4th Street through streetscape enhancements, while the City of Loveland Water and Power Department works on upgrades to the utility infrastructure beneath the road. As this project is a significant effort, the City of Loveland and the Loveland Downtown Development Authority (DDA) have come together to finally bring this portion of the Heart Improvement Plan to fruition. We’re excited to reimagine our Downtown and it all starts with 4th Street.

Our project team is composed of local industry professionals who understand the importance of these improvements and are committed to making this a project our community can be proud of while embracing our historic core and creating a vibrant space that highlights our artistic community.

Project Vision

Create a functional, aesthetically pleasing, eclectic Downtown environment that facilitates business vitality, fosters a sense of community, and accentuates the identity of the Downtown commercial district.

Incorporate streetscaping as part of an existing major infrastructure project to minimize business impact and improve the built environment.

Project Impacts

By late February 2025, the City of Loveland aims to begin construction, starting with underground water and stormwater utility improvements. Once infrastructure improvements are complete, the City of Loveland will focus on surface improvements determined by the streetscape design. Between utility and streetscape improvements, each block is anticipated to take six to eight months to construct.

Pedestrian access to 4th Street businesses will remain open throughout the project, however, the road will be closed to vehicular traffic. Visitors can access the corridor by parking in lots along 5th Street and by using other nearby designated on-street parking. Visit the downtown parking webpage for a map of available parking options.

Updates

  • Adopted Concept Plans (2009)
  • Parking Studies (2018/2019)
  • Revised Modernization Plan (2017)
  • Infrastructure Assessment (2019)
  • 4th Street Construction Design and Drawings (2023)
    • Parking study updated
    • Present updated plans to LRFA, City Planning Commission, Loveland Parks and Recreation, APP, City Management and DDA Board (07/2023-08/2023)
    • First Open House at The Foundry to review public input (08/23/2023)
    • Second Open House at the Desk Chair Workspace to gather additional input (12/12/2023)
    • City Council Update (01/23/2024)

Project Goals

  • Focus on Economic Vitality
    • Attract new downtown visitors and patrons to encourage tourism
    • Minimize construction disruption
    • Finish the project with no business loss or claims
    • Allow for efficient access, parking and circulation
    • Catalyze business potential in under-utilized areas
  • Create a Comfortable and Inviting Downtown Experience Unique to Loveland
    • Create a safe environment that is activated at night and day
    • Develop a vibrant, engaging and unique streetscape as a regional destination
    • Capitalize on artistic spirit and attitude towards placemaking
    • Build upon the unique Downtown Loveland identity
    • Incorporate art and culture in design and user experience
    • Identity and History, unique to Loveland
  • Create a Flexible and Adaptable Streetscape
    • Flexible and functional space for a variety of uses
    • Allow for ease of seasonal programming needs
    • Inviting and appealing place for a broad demographic to stimulate diverse businesses
    • Design and build an easily maintained space
    • Create more safe and comfortable walking/pedestrian zones
  • Foster Partnerships for Long Term Success
    • Provide for sustained stakeholder engagement
    • Ensure Downtown Business support throughout project

Project Funding

On Tuesday, Nov. 19, 2024, Loveland’s City Council unanimously approved using Certificates of Participation (COPs) to help fund the Heart Improvement Plan’s 4th Street Revitalization project. The $24.5 million project will be paid for through a mix of Utility Enterprise Funds and COPs. Utility Enterprise Funds (Stormwater, Water and Power) will contribute $12 million, while the remaining $12.5 million will come from COPs paid by the Downtown Development Authority (DDA). No General Funds will be used for this project.

Stay Informed During Construction

Whether you live outside downtown or are directly affected by the construction, we have project updates tailored to your needs.

  • General Public Updates: Receive updates on essential project news, major milestones, city-wide impacts, and opportunities to get involved in marketing and community events.
  • Downtown Business/Resident Updates: Receive detailed information about construction impacts, traffic changes, neighborhood-specific updates, and how your business can participate in marketing campaigns and support programs.

To sign up for the project newsletter, join the Heart Improvement Plan Email List. To contact the project team, call the Public Works Department at 970-962-2524 or email HIPStreets@cityofloveland.org. Please allow at least 24-48 hours for a response. Thank you!

  • Weekly project update 6/1/26 - 6/7/26

    Share Weekly project update 6/1/26 - 6/7/26 on Facebook Share Weekly project update 6/1/26 - 6/7/26 on Twitter Share Weekly project update 6/1/26 - 6/7/26 on Linkedin Email Weekly project update 6/1/26 - 6/7/26 link

    Hello Stakeholders!

    Here are the project updates for the week of 6/1/26 – 06/7/26:

    • Cleveland Avenue
      • Concrete work has been completed on the south side of Cleveland at the 4th Street intersection, and traffic lanes and on-street parking are now open.

    • Block 3 (Lincoln to Cleveland Ave.)
      • Block remains closed to vehicle traffic; businesses are open to pedestrian access.
      • Sidewalk and boulder seatwall work continues. Concrete paving is nearing completion.

    • Block 4 (Cleveland to N. Railroad Ave.)
      • Block remains closed to vehicle traffic; businesses are open to pedestrian access.
      • Electrical conduit and light pole foundations are nearing completion.
      • Grading begins in preparation for concrete bollard bands and paving.

    Weather permitting, work activities are Monday-Friday, 5:00 a.m. – 7:00 p.m. Please contact us with any questions at HipStreets@cityofloveland.org or 970-962-2524.

    Thank you for your continued patience and support.

    Hello Stakeholders!

    Here are the project updates for the week of 6/1/26 – 06/7/26:

    • Cleveland Avenue
      • Concrete work has been completed on the south side of Cleveland at the 4th Street intersection, and traffic lanes and on-street parking are now open.

    • Block 3 (Lincoln to Cleveland Ave.)
      • Block remains closed to vehicle traffic; businesses are open to pedestrian access.
      • Sidewalk and boulder seatwall work continues. Concrete paving is nearing completion.

    • Block 4 (Cleveland to N. Railroad Ave.)
      • Block remains closed to vehicle traffic; businesses are open to pedestrian access.
      • Electrical conduit and light pole foundations are nearing completion.
      • Grading begins in preparation for concrete bollard bands and paving.

    Weather permitting, work activities are Monday-Friday, 5:00 a.m. – 7:00 p.m. Please contact us with any questions at HipStreets@cityofloveland.org or 970-962-2524.

    Thank you for your continued patience and support.

  • Weekly project update 5/25/26 - 5/31/26

    Share Weekly project update 5/25/26 - 5/31/26 on Facebook Share Weekly project update 5/25/26 - 5/31/26 on Twitter Share Weekly project update 5/25/26 - 5/31/26 on Linkedin Email Weekly project update 5/25/26 - 5/31/26 link

    Hello Stakeholders!

    Here are the project updates for the week of 5/25/26-5/31/26:

    • No work Monday, May 25th in observance of Memorial Day
    • Cleveland Avenue
      • West on-street parking closures between E. 4th and E. 5th Streets.
      • East on-street parking closures between Backstage Alley and E. 6th Street.
      • East/southbound lane closure at E. 4th Street daily from 8:30 AM – 3:30 PM; open at night/early mornings.
    • Block 3 (Lincoln to Cleveland Ave.)
      • Block remains closed to vehicle traffic; businesses are open to pedestrian access.
      • Boulder seatwalls, electric conduit and concrete work, including panel replacements in the roadway.
    • Block 4 (Cleveland to N. Railroad Ave.)
      • Block remains closed to vehicle traffic; businesses are open to pedestrian access.
      • Boulder seatwalls and streetlight bases.
    • Sweetheart Alley (Lincoln to Cleveland Ave.) (non-project related work)
      • Power work is complete and the alley is reopened.
      • A dumpster will still be present behind 209 E. 4th St.
    • Backstage Alley (west of Cleveland Ave.) (non-project related work)
      • Daily/workday closures and limited access.
      • CenturyLink conduit installations.
    • Cleveland Ave. and E 6thSt. (non-project related work)
      • Utility investigations and potholing work is complete.

    Weather permitting, work activities are Monday-Friday, 5:00 a.m. – 7:00 p.m. Please contact us with any questions at HipStreets@cityofloveland.org or 970-962-2524.

    Thank you for your continued patience and support.

    Hello Stakeholders!

    Here are the project updates for the week of 5/25/26-5/31/26:

    • No work Monday, May 25th in observance of Memorial Day
    • Cleveland Avenue
      • West on-street parking closures between E. 4th and E. 5th Streets.
      • East on-street parking closures between Backstage Alley and E. 6th Street.
      • East/southbound lane closure at E. 4th Street daily from 8:30 AM – 3:30 PM; open at night/early mornings.
    • Block 3 (Lincoln to Cleveland Ave.)
      • Block remains closed to vehicle traffic; businesses are open to pedestrian access.
      • Boulder seatwalls, electric conduit and concrete work, including panel replacements in the roadway.
    • Block 4 (Cleveland to N. Railroad Ave.)
      • Block remains closed to vehicle traffic; businesses are open to pedestrian access.
      • Boulder seatwalls and streetlight bases.
    • Sweetheart Alley (Lincoln to Cleveland Ave.) (non-project related work)
      • Power work is complete and the alley is reopened.
      • A dumpster will still be present behind 209 E. 4th St.
    • Backstage Alley (west of Cleveland Ave.) (non-project related work)
      • Daily/workday closures and limited access.
      • CenturyLink conduit installations.
    • Cleveland Ave. and E 6thSt. (non-project related work)
      • Utility investigations and potholing work is complete.

    Weather permitting, work activities are Monday-Friday, 5:00 a.m. – 7:00 p.m. Please contact us with any questions at HipStreets@cityofloveland.org or 970-962-2524.

    Thank you for your continued patience and support.

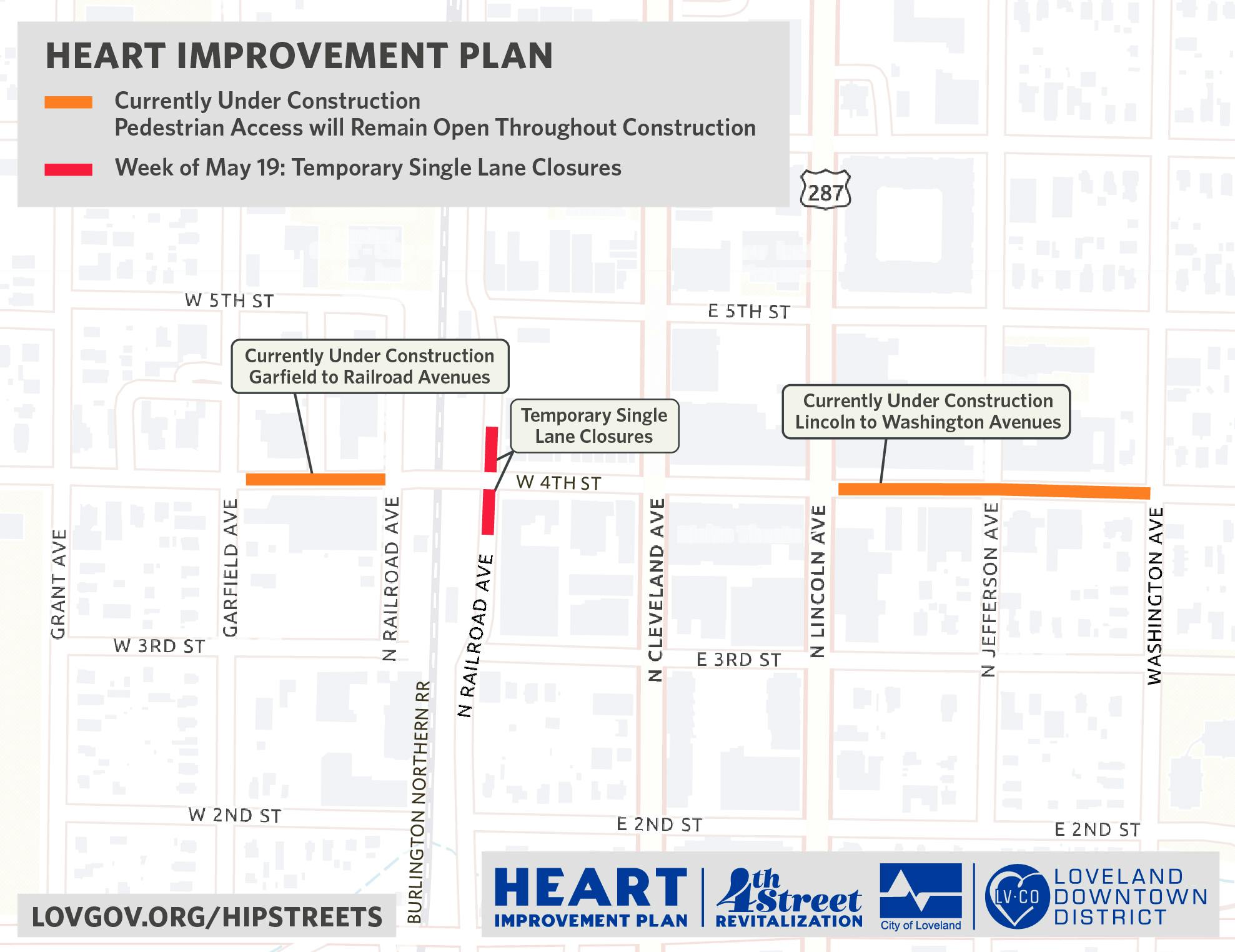

  • Weekly project update 5/18/26 - 5/24/26

    Share Weekly project update 5/18/26 - 5/24/26 on Facebook Share Weekly project update 5/18/26 - 5/24/26 on Twitter Share Weekly project update 5/18/26 - 5/24/26 on Linkedin Email Weekly project update 5/18/26 - 5/24/26 link

    Hello Loveland!

    Here are the project updates for the week of 5/18/26-5/24/26:

    • Block 1 (Washington to Jefferson)

    o Flagging operations at 4th & Washington Ave. for storm system jetting.

    • Block 3 (Lincoln to Cleveland Ave.)

    o Block remains closed to vehicle traffic; businesses are open to pedestrian access.

    o Boulder seatwalls, electric conduit and concrete work, including panel replacements in the roadway.

    • Block 4 (Cleveland to N. Railroad Ave.)

    o Block remains closed to vehicle traffic; businesses are open to pedestrian access.

    o Power conduit and light pole base installations.

    • Sweetheart Alley (Lincoln to Cleveland Ave.) (non-project related work)

    o Daily/workday closures and limited access.

    o Electric meter replacements and transformer upgrades.

    • Backstage Alley (west of Cleveland Ave.) (non-project related work)

    o Daily/workday closures and limited access.

    o CenturyLink conduit installations.

    • Cleveland Ave. and E 6th St. (non-project related work)

    o On-street parking closures and lane shifts.

    o Utility investigations and potholing.

    Weather permitting, work activities are Monday-Friday, 5:00 a.m. – 7:00 p.m. Please contact us with any questions at HipStreets@cityofloveland.org or 970-962-2524.

    Thank you for your continued patience and support.

    Hello Loveland!

    Here are the project updates for the week of 5/18/26-5/24/26:

    • Block 1 (Washington to Jefferson)

    o Flagging operations at 4th & Washington Ave. for storm system jetting.

    • Block 3 (Lincoln to Cleveland Ave.)

    o Block remains closed to vehicle traffic; businesses are open to pedestrian access.

    o Boulder seatwalls, electric conduit and concrete work, including panel replacements in the roadway.

    • Block 4 (Cleveland to N. Railroad Ave.)

    o Block remains closed to vehicle traffic; businesses are open to pedestrian access.

    o Power conduit and light pole base installations.

    • Sweetheart Alley (Lincoln to Cleveland Ave.) (non-project related work)

    o Daily/workday closures and limited access.

    o Electric meter replacements and transformer upgrades.

    • Backstage Alley (west of Cleveland Ave.) (non-project related work)

    o Daily/workday closures and limited access.

    o CenturyLink conduit installations.

    • Cleveland Ave. and E 6th St. (non-project related work)

    o On-street parking closures and lane shifts.

    o Utility investigations and potholing.

    Weather permitting, work activities are Monday-Friday, 5:00 a.m. – 7:00 p.m. Please contact us with any questions at HipStreets@cityofloveland.org or 970-962-2524.

    Thank you for your continued patience and support.

  • Weekly project update 5/11/26 - 5/17/26

    Share Weekly project update 5/11/26 - 5/17/26 on Facebook Share Weekly project update 5/11/26 - 5/17/26 on Twitter Share Weekly project update 5/11/26 - 5/17/26 on Linkedin Email Weekly project update 5/11/26 - 5/17/26 link

    Hello Loveland —

    Here are the project updates for the week of 5/11/26 - 5/17/26:

    • Lincoln Avenue
      • West on-street parking closures between E. 3rd Street and Sweetheart Alley.
      • West lane closure at E. 4th Street: Daily (Monday through Friday) from 8:30 AM – 3:30 PM.
    • Block 3 (Lincoln to Cleveland Ave.)
      • Block remains closed to vehicle traffic; businesses are open to pedestrian access.
      • Boulder seatwalls, irrigation installations and concrete work.
    • Block 4 (Cleveland to N. Railroad Ave.)
      • Block remains closed to vehicle traffic; businesses are open to pedestrian access.
      • Storm sewer, power conduit and light pole base installations.
    • Sweetheart Alley (Lincoln to Cleveland Ave.) (non-project related work)
      • Daily/workday closures and limited access.
      • Electric meter replacements and transformer upgrades.
    • Backstage Alley (Lincoln to Cleveland Ave.) (non-project related work)
      • Daily/workday closures and limited access.
      • CenturyLink conduit installations.

    Weather permitting, work activities are Monday-Friday, 5:00 a.m. – 7:00 p.m. Please contact us with any questions at HipStreets@cityofloveland.org or 970-962-2524.

    Thank you for your continued patience and support.

    Hello Loveland —

    Here are the project updates for the week of 5/11/26 - 5/17/26:

    • Lincoln Avenue
      • West on-street parking closures between E. 3rd Street and Sweetheart Alley.
      • West lane closure at E. 4th Street: Daily (Monday through Friday) from 8:30 AM – 3:30 PM.
    • Block 3 (Lincoln to Cleveland Ave.)
      • Block remains closed to vehicle traffic; businesses are open to pedestrian access.
      • Boulder seatwalls, irrigation installations and concrete work.
    • Block 4 (Cleveland to N. Railroad Ave.)
      • Block remains closed to vehicle traffic; businesses are open to pedestrian access.
      • Storm sewer, power conduit and light pole base installations.
    • Sweetheart Alley (Lincoln to Cleveland Ave.) (non-project related work)
      • Daily/workday closures and limited access.
      • Electric meter replacements and transformer upgrades.
    • Backstage Alley (Lincoln to Cleveland Ave.) (non-project related work)
      • Daily/workday closures and limited access.
      • CenturyLink conduit installations.

    Weather permitting, work activities are Monday-Friday, 5:00 a.m. – 7:00 p.m. Please contact us with any questions at HipStreets@cityofloveland.org or 970-962-2524.

    Thank you for your continued patience and support.

  • Update as of 5/4/26: Lincoln Avenue

    Share Update as of 5/4/26: Lincoln Avenue on Facebook Share Update as of 5/4/26: Lincoln Avenue on Twitter Share Update as of 5/4/26: Lincoln Avenue on Linkedin Email Update as of 5/4/26: Lincoln Avenue link

    Sidewalk replacement work on Lincoln Avenue has been rescheduled due to expected inclement weather this week.

    To maintain the overall project schedule, the following traffic and parking impacts are planned for May 11–15:

    • West on‑street parking closures between E. 3rd Street and Sweetheart Alley
    • West lane closure at E. 4th Street, 8:30 AM–3:30 PM daily
      • Flaggers will assist pedestrians crossing Lincoln Avenue
      • Standard signal phasing will be in place during evenings
      • Please follow pedestrian fencing and signage directing people walking through the area

    Sidewalk replacement work on Lincoln Avenue has been rescheduled due to expected inclement weather this week.

    To maintain the overall project schedule, the following traffic and parking impacts are planned for May 11–15:

    • West on‑street parking closures between E. 3rd Street and Sweetheart Alley
    • West lane closure at E. 4th Street, 8:30 AM–3:30 PM daily
      • Flaggers will assist pedestrians crossing Lincoln Avenue
      • Standard signal phasing will be in place during evenings
      • Please follow pedestrian fencing and signage directing people walking through the area

  • Weekly project update 5/4/26 - 5/10/26

    Share Weekly project update 5/4/26 - 5/10/26 on Facebook Share Weekly project update 5/4/26 - 5/10/26 on Twitter Share Weekly project update 5/4/26 - 5/10/26 on Linkedin Email Weekly project update 5/4/26 - 5/10/26 link

    Hello Loveland,

    Here are the project updates for next week (5/4/26-5/10/26):

    • Lincoln Avenue
      • West on-street parking closures between E. 3rd Street and Sweetheart Alley
      • West lane closure at E. 4th Street: 8:30 AM – 3:30 PM on Monday, May 5 and Wednesday, May 7.
    • Block 2 (Jefferson to Lincoln Ave.)
      • On-street parking closed.
      • Block will be closed to vehicles for approximately one day for landscaping installations. Sidewalks will remain open.
    • Block 3 (Lincoln to Cleveland Ave.)
      • Block remains closed to vehicle traffic; businesses are open to pedestrian access.
      • Boulder seatwalls and concrete.
    • Block 4 (Cleveland to N. Railroad Ave.)
      • Block remains closed to vehicle traffic; businesses are open to pedestrian access.
      • Storm sewer, power conduit and light pole base installations.
    • Sweetheart Alley (Lincoln to Cleveland Ave.) (non-project related work)
      • Daily/workday closures and limited access.
      • Electric meter replacements and transformer upgrades.
    • Backstage Alley (Lincoln to Cleveland Ave.) (non-project related work)
      • Daily/workday closures and limited access.
      • CenturyLink conduit installations.

    Weather permitting, work activities are Monday-Friday, 5:00 a.m. – 7:00 p.m. Please contact us with any questions at HipStreets@cityofloveland.org or 970-962-2524.

    Thank you for your continued patience and support.

    Hello Loveland,

    Here are the project updates for next week (5/4/26-5/10/26):

    • Lincoln Avenue
      • West on-street parking closures between E. 3rd Street and Sweetheart Alley
      • West lane closure at E. 4th Street: 8:30 AM – 3:30 PM on Monday, May 5 and Wednesday, May 7.
    • Block 2 (Jefferson to Lincoln Ave.)
      • On-street parking closed.
      • Block will be closed to vehicles for approximately one day for landscaping installations. Sidewalks will remain open.
    • Block 3 (Lincoln to Cleveland Ave.)
      • Block remains closed to vehicle traffic; businesses are open to pedestrian access.
      • Boulder seatwalls and concrete.
    • Block 4 (Cleveland to N. Railroad Ave.)
      • Block remains closed to vehicle traffic; businesses are open to pedestrian access.
      • Storm sewer, power conduit and light pole base installations.
    • Sweetheart Alley (Lincoln to Cleveland Ave.) (non-project related work)
      • Daily/workday closures and limited access.
      • Electric meter replacements and transformer upgrades.
    • Backstage Alley (Lincoln to Cleveland Ave.) (non-project related work)
      • Daily/workday closures and limited access.
      • CenturyLink conduit installations.

    Weather permitting, work activities are Monday-Friday, 5:00 a.m. – 7:00 p.m. Please contact us with any questions at HipStreets@cityofloveland.org or 970-962-2524.

    Thank you for your continued patience and support.

  • Weekly project update 4/27/26 - 5/3/26

    Share Weekly project update 4/27/26 - 5/3/26 on Facebook Share Weekly project update 4/27/26 - 5/3/26 on Twitter Share Weekly project update 4/27/26 - 5/3/26 on Linkedin Email Weekly project update 4/27/26 - 5/3/26 link

    Hello Stakeholders!

    Here are the project updates for this week (4/27/26-5/3/26).

    • Crews will occasionally begin work as early as 5-6 AM to install building thresholds before businesses open.
    • Block 1 (Washington to Jefferson Ave.)
      • On-street parking closed.
      • Block will be closed to vehicles for approximately one day for landscaping installations. Sidewalks will remain open.
    • Block 3 (Lincoln to Cleveland Ave.)
      • Block remains closed to vehicle traffic; businesses are open to pedestrian access.
      • Boulder seatwalls, concrete and electric work.
    • Block 4 (Cleveland to N. Railroad Ave.)
      • Block remains closed to vehicle traffic; businesses are open to pedestrian access.
      • Storm sewer and power conduit installations.
    • Sweetheart Alley (Lincoln to Cleveland Ave.) (non-project related work)
      • Daily/workday closures and limited access.
      • Electric meter replacements and transformer upgrades.

    Weather permitting, work activities are Monday-Friday, 7:00 a.m. – 7:00 p.m. Please contact us with any questions at HipStreets@cityofloveland.org or 970-962-2524.

    Thank you for your continued patience and support.

    Hello Stakeholders!

    Here are the project updates for this week (4/27/26-5/3/26).

    • Crews will occasionally begin work as early as 5-6 AM to install building thresholds before businesses open.
    • Block 1 (Washington to Jefferson Ave.)
      • On-street parking closed.
      • Block will be closed to vehicles for approximately one day for landscaping installations. Sidewalks will remain open.
    • Block 3 (Lincoln to Cleveland Ave.)
      • Block remains closed to vehicle traffic; businesses are open to pedestrian access.
      • Boulder seatwalls, concrete and electric work.
    • Block 4 (Cleveland to N. Railroad Ave.)
      • Block remains closed to vehicle traffic; businesses are open to pedestrian access.
      • Storm sewer and power conduit installations.
    • Sweetheart Alley (Lincoln to Cleveland Ave.) (non-project related work)
      • Daily/workday closures and limited access.
      • Electric meter replacements and transformer upgrades.

    Weather permitting, work activities are Monday-Friday, 7:00 a.m. – 7:00 p.m. Please contact us with any questions at HipStreets@cityofloveland.org or 970-962-2524.

    Thank you for your continued patience and support.

  • Weekly project update 4/20/26 - 4/26/26

    Share Weekly project update 4/20/26 - 4/26/26 on Facebook Share Weekly project update 4/20/26 - 4/26/26 on Twitter Share Weekly project update 4/20/26 - 4/26/26 on Linkedin Email Weekly project update 4/20/26 - 4/26/26 link

    Hello Stakeholders!

    Here are the project updates for this week (4/20/26-4/26/26).

    • Cleveland Avenue
      • Parking closures and alternating lane sifts for striping activities.
      • Major work on Cleveland will be completed this week!
    • Block 3 (Lincoln to Cleveland Avenue)
      • Block remains closed to vehicle traffic; sidewalks are open to pedestrian access.
      • Boulder seatwalls, concrete and electric work.
    • Block 4 (Cleveland to north Railroad Avenue)
      • Block remains closed to vehicle traffic; sidewalks are open to pedestrian access.
      • Storm sewer and power conduit installations.
    • North Railroad Avenue (east)
      • Intersection is closed
      • Utility installation
    • Block 5 (Railroad Avenue (west) to Garfield Avenue.)
      • Block will be closed to vehicles for approximately four days for landscaping installations. Sidewalks will remain open.

    Weather permitting, work activities are Monday-Friday, 7:00 a.m. – 7:00 p.m. Please contact us with any questions at HIPStreets@cityofloveland.org or 970-962-2524.

    Thank you for your continued support as we revitalize 4th Street!

    Hello Stakeholders!

    Here are the project updates for this week (4/20/26-4/26/26).

    • Cleveland Avenue
      • Parking closures and alternating lane sifts for striping activities.
      • Major work on Cleveland will be completed this week!
    • Block 3 (Lincoln to Cleveland Avenue)
      • Block remains closed to vehicle traffic; sidewalks are open to pedestrian access.
      • Boulder seatwalls, concrete and electric work.
    • Block 4 (Cleveland to north Railroad Avenue)
      • Block remains closed to vehicle traffic; sidewalks are open to pedestrian access.
      • Storm sewer and power conduit installations.
    • North Railroad Avenue (east)
      • Intersection is closed
      • Utility installation
    • Block 5 (Railroad Avenue (west) to Garfield Avenue.)
      • Block will be closed to vehicles for approximately four days for landscaping installations. Sidewalks will remain open.

    Weather permitting, work activities are Monday-Friday, 7:00 a.m. – 7:00 p.m. Please contact us with any questions at HIPStreets@cityofloveland.org or 970-962-2524.

    Thank you for your continued support as we revitalize 4th Street!

  • Weekly project update 4/13/26 - 4/19/26

    Share Weekly project update 4/13/26 - 4/19/26 on Facebook Share Weekly project update 4/13/26 - 4/19/26 on Twitter Share Weekly project update 4/13/26 - 4/19/26 on Linkedin Email Weekly project update 4/13/26 - 4/19/26 link

    Hello, Loveland!

    Here are the project updates for this week (4/13/26-4/19/26).

    • Cleveland Avenue
      • Southbound Cleveland Avenue will remain in a single-lane configuration.
    • Block 3 (Lincoln to Cleveland Avenue)
      • Block remains closed to vehicle traffic; sidewalks are open to pedestrian access.
      • Boulder seatwall, concrete and electric work.
      • Non-project related façade work (209 E. 4th Street). Sidewalk impacts.
    • Block 4 (Cleveland to N. Railroad Avenue)
      • Block remains closed to vehicle traffic; sidewalks are open to pedestrian access.
      • Fireline installations.
      • Storm sewer installations.
    • Block 5 (Railroad Avenue west to Garfield Avenue)
      • Landscaping installations.
    • N. Railroad Avenue (east)
      • Intersection closure (Area 1 below).
      • Utility installations.

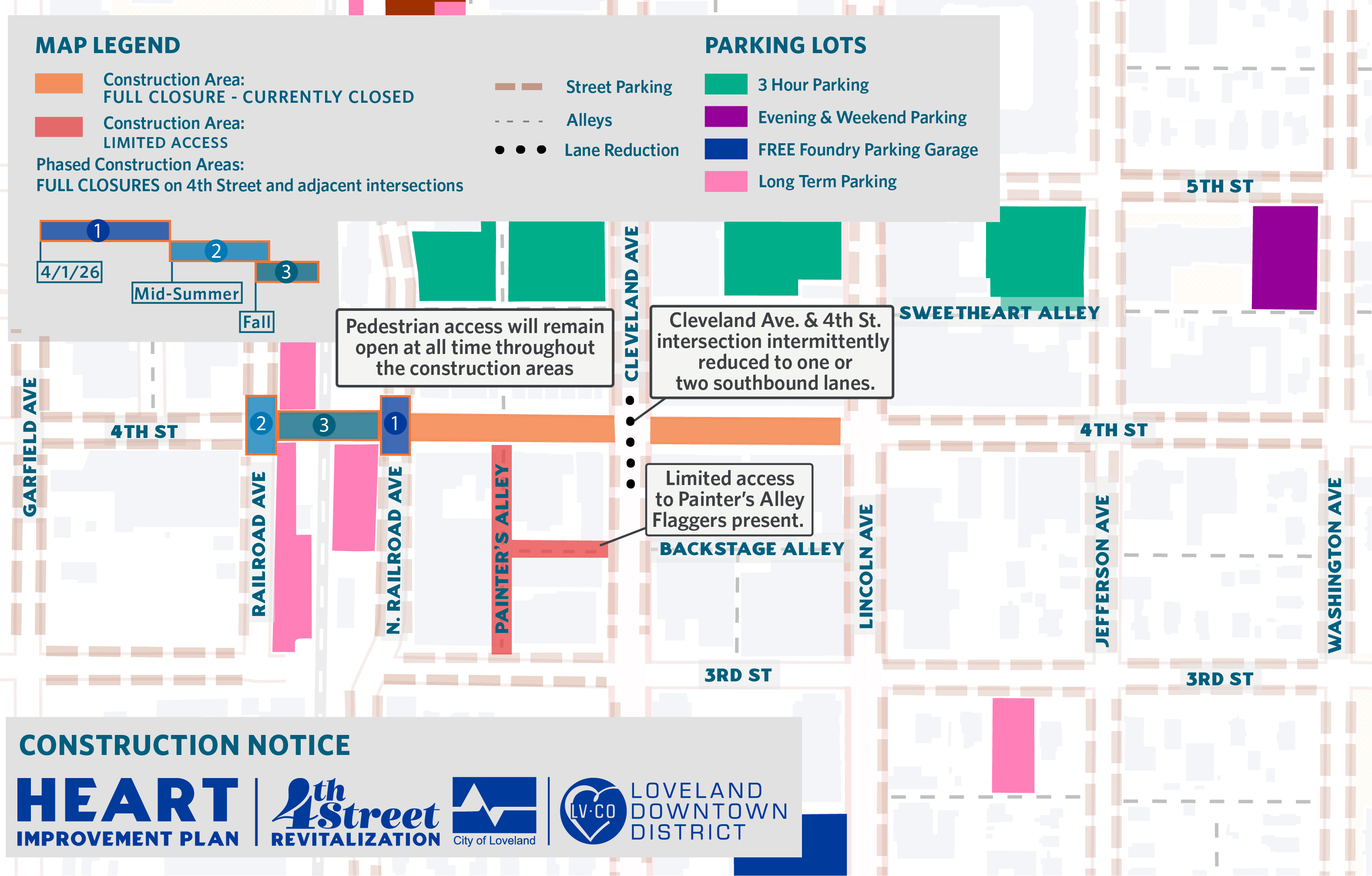

    • Painters Alley (non-project related)
      • Vault installation, Loveland Utilities.

    Weather permitting, work activities are Monday-Friday, 7:00 a.m. – 7:00 p.m. Please contact us with any questions at HIPStreets@cityofloveland.org or 970-962-2524.

    Thank you for your continued support as we revitalize 4th Street!

    Hello, Loveland!

    Here are the project updates for this week (4/13/26-4/19/26).

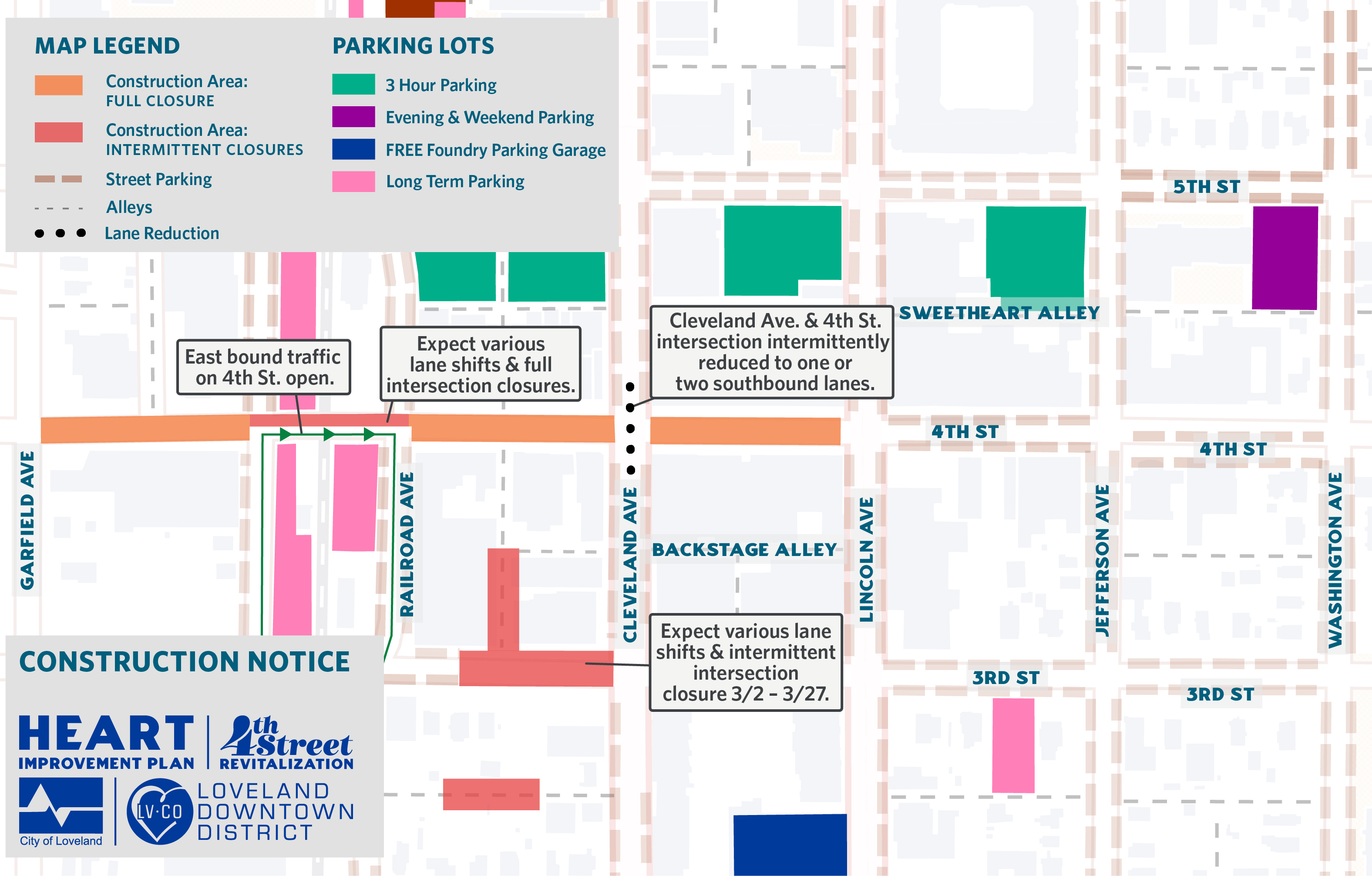

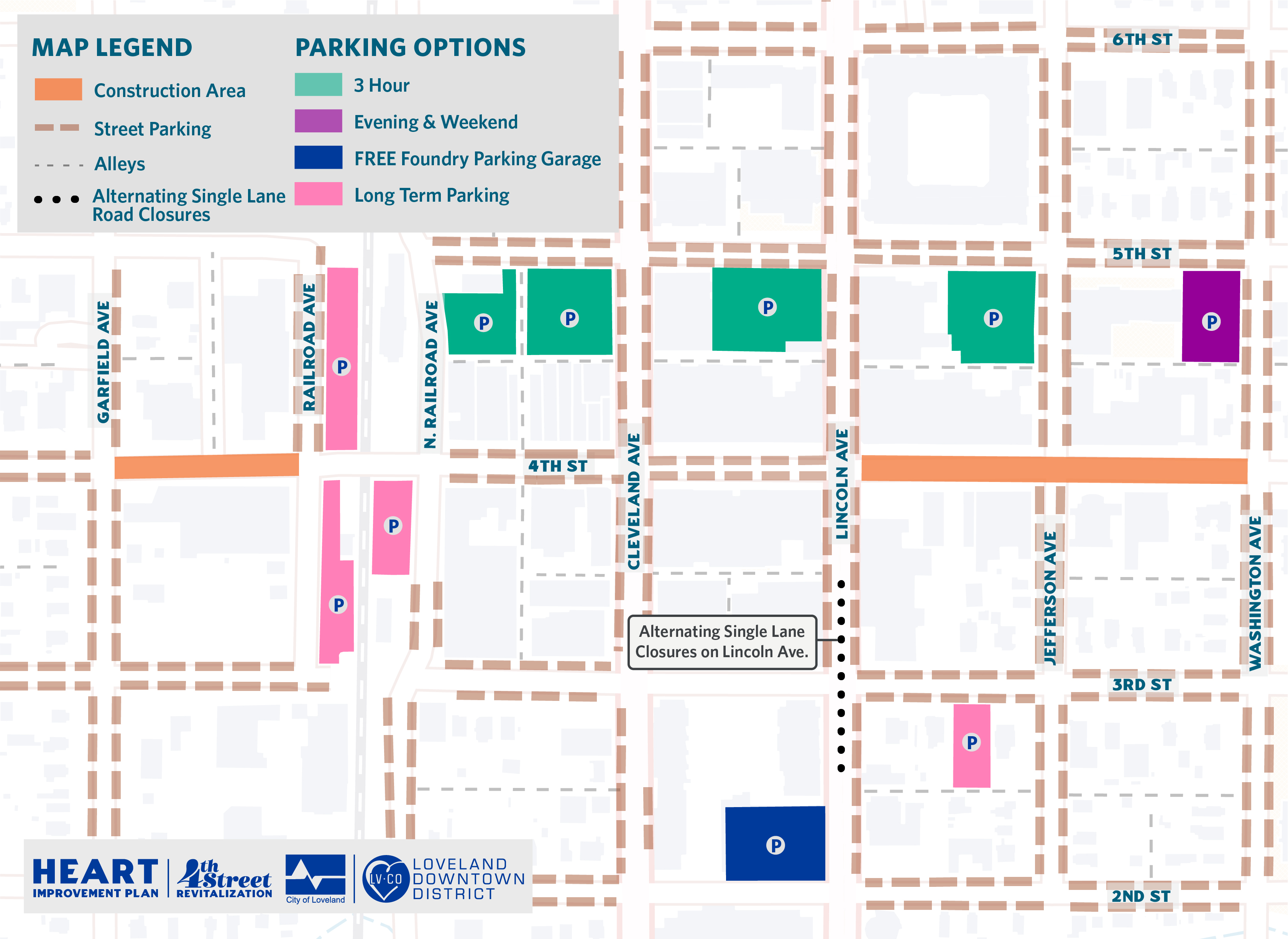

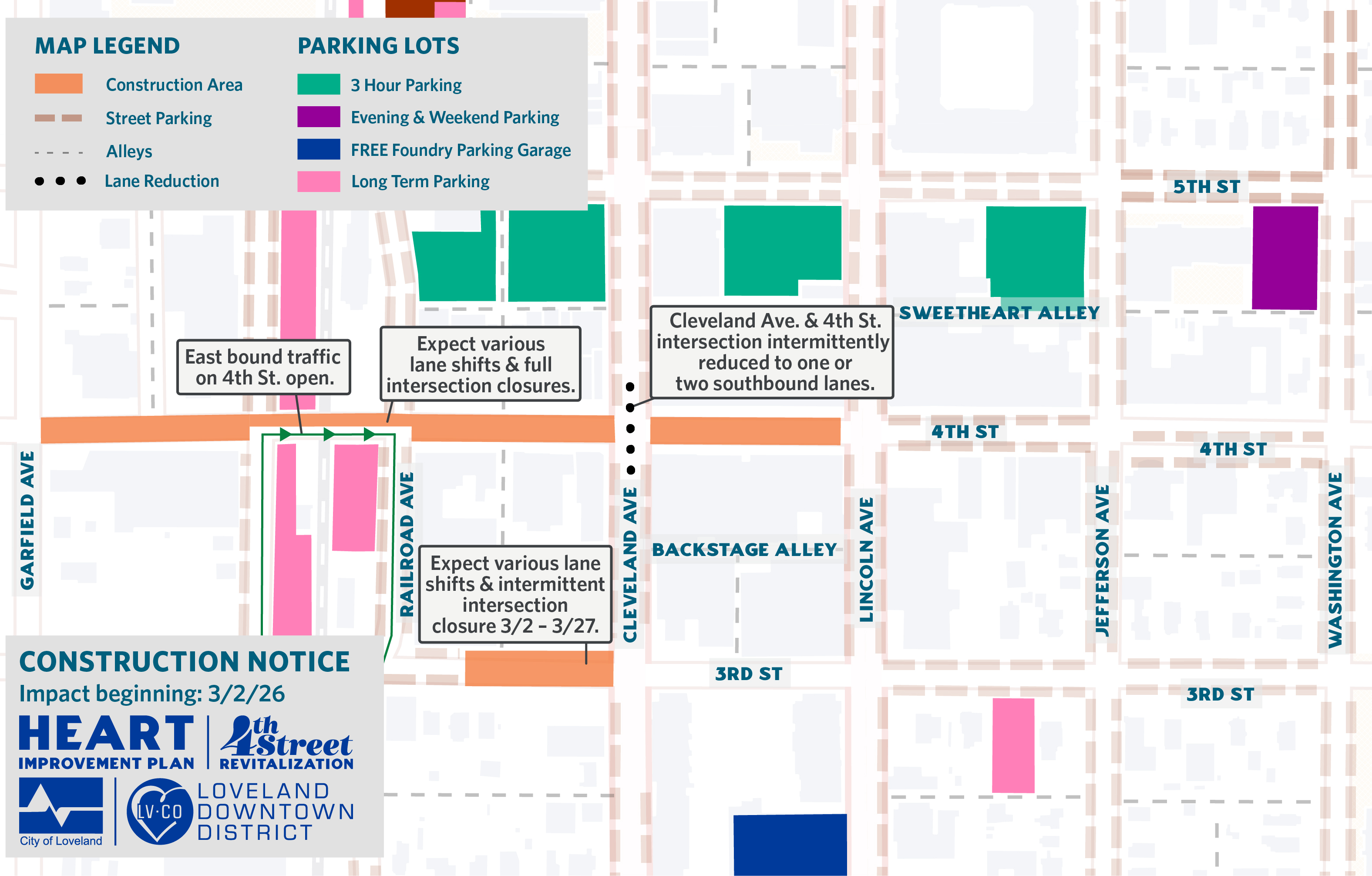

    • Cleveland Avenue
      • Southbound Cleveland Avenue will remain in a single-lane configuration.
    • Block 3 (Lincoln to Cleveland Avenue)
      • Block remains closed to vehicle traffic; sidewalks are open to pedestrian access.
      • Boulder seatwall, concrete and electric work.
      • Non-project related façade work (209 E. 4th Street). Sidewalk impacts.
    • Block 4 (Cleveland to N. Railroad Avenue)
      • Block remains closed to vehicle traffic; sidewalks are open to pedestrian access.
      • Fireline installations.
      • Storm sewer installations.
    • Block 5 (Railroad Avenue west to Garfield Avenue)
      • Landscaping installations.
    • N. Railroad Avenue (east)
      • Intersection closure (Area 1 below).
      • Utility installations.
    • Painters Alley (non-project related)
      • Vault installation, Loveland Utilities.

    Weather permitting, work activities are Monday-Friday, 7:00 a.m. – 7:00 p.m. Please contact us with any questions at HIPStreets@cityofloveland.org or 970-962-2524.

    Thank you for your continued support as we revitalize 4th Street!

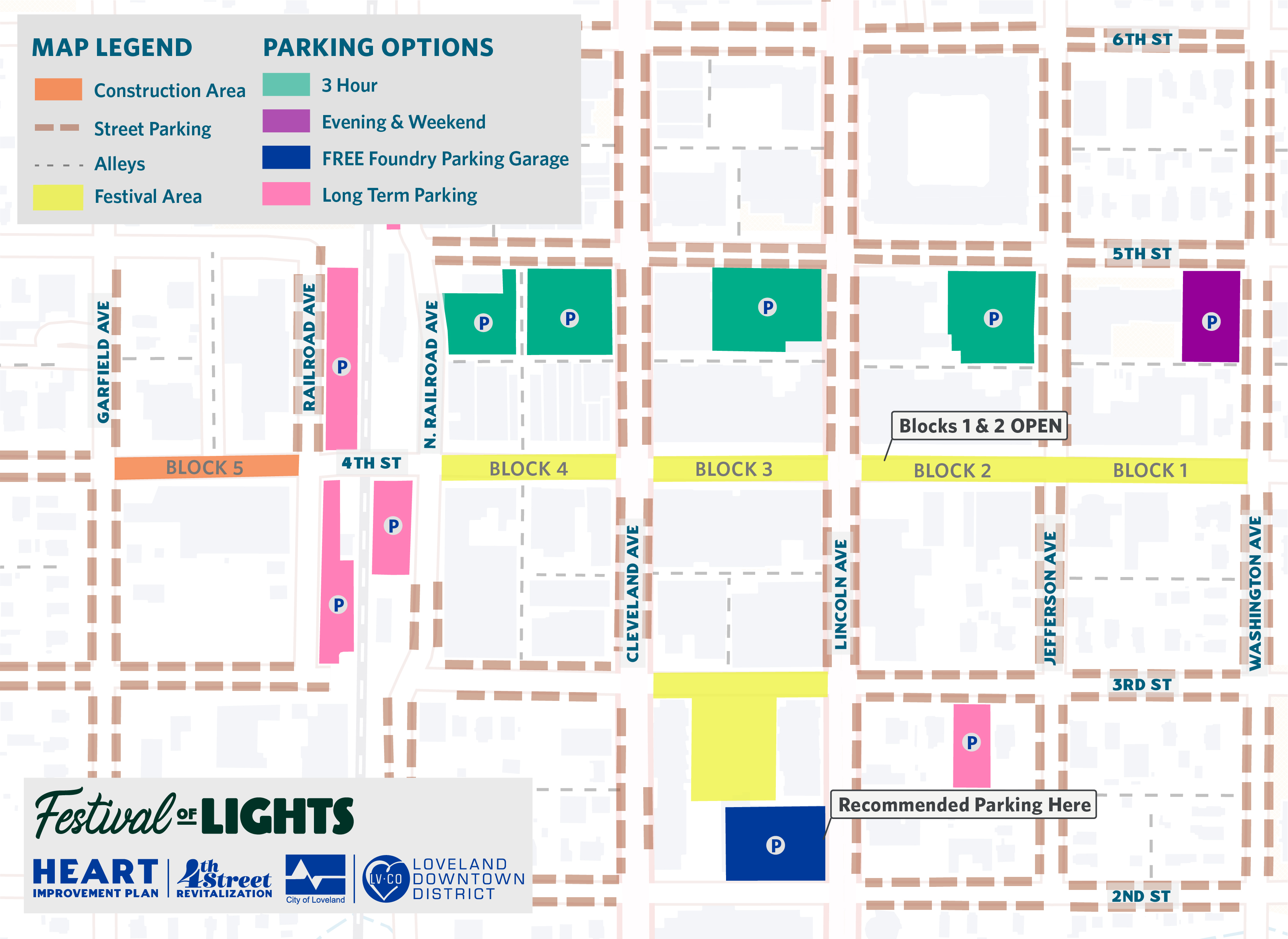

  • Weekly project update 4/6/26 - 4/12/26

    Share Weekly project update 4/6/26 - 4/12/26 on Facebook Share Weekly project update 4/6/26 - 4/12/26 on Twitter Share Weekly project update 4/6/26 - 4/12/26 on Linkedin Email Weekly project update 4/6/26 - 4/12/26 link

Page last updated: 29 May 2026, 03:31 PM
