The Garfield-Harrison Project is a large-scale master planned Stormwater project that began in January 2022. The City of Loveland has contracted with Connell Resources to build the Garfield Harrison Storm Drainage Improvements Project. The four separate phases are expected to occur over the next four years (approximately one phase per year.) The project addresses the multiple drainage problems caused by aging infrastructure in the west part of downtown Loveland. Partnering with the City’s Water and Wastewater divisions, Street Maintenance and Rehabilitation Program, and Stormwater Engineering, the project will include new waterlines, sanitary sewers, street resurfacing, and various concrete repairs that will improve ADA accessibility.
The four-year project is designed to improve the following:
Implementation of the City of Loveland Master Drainage Plan
Replacing and upgrading existing stormwater infrastructure to address existing drainage issues and meet current stormwater standards
Installing 18- to 60-inch diameter storm sewer pipes
Replacing existing waterlines and valves to address aging infrastructure
Replacing pavement including asphalt patching, milling, overlays, or full street reconstruction where project components are installed
Rehabilitating and replacing concrete, as well as adding necessary ADA improvements
Disconnecting stormwater from the Little Barnes Ditch during Phase 4
Providing stormwater quality treatment measures within the stormwater system
The four-phase project is expected to be completed in fall 2027.
Phase 3

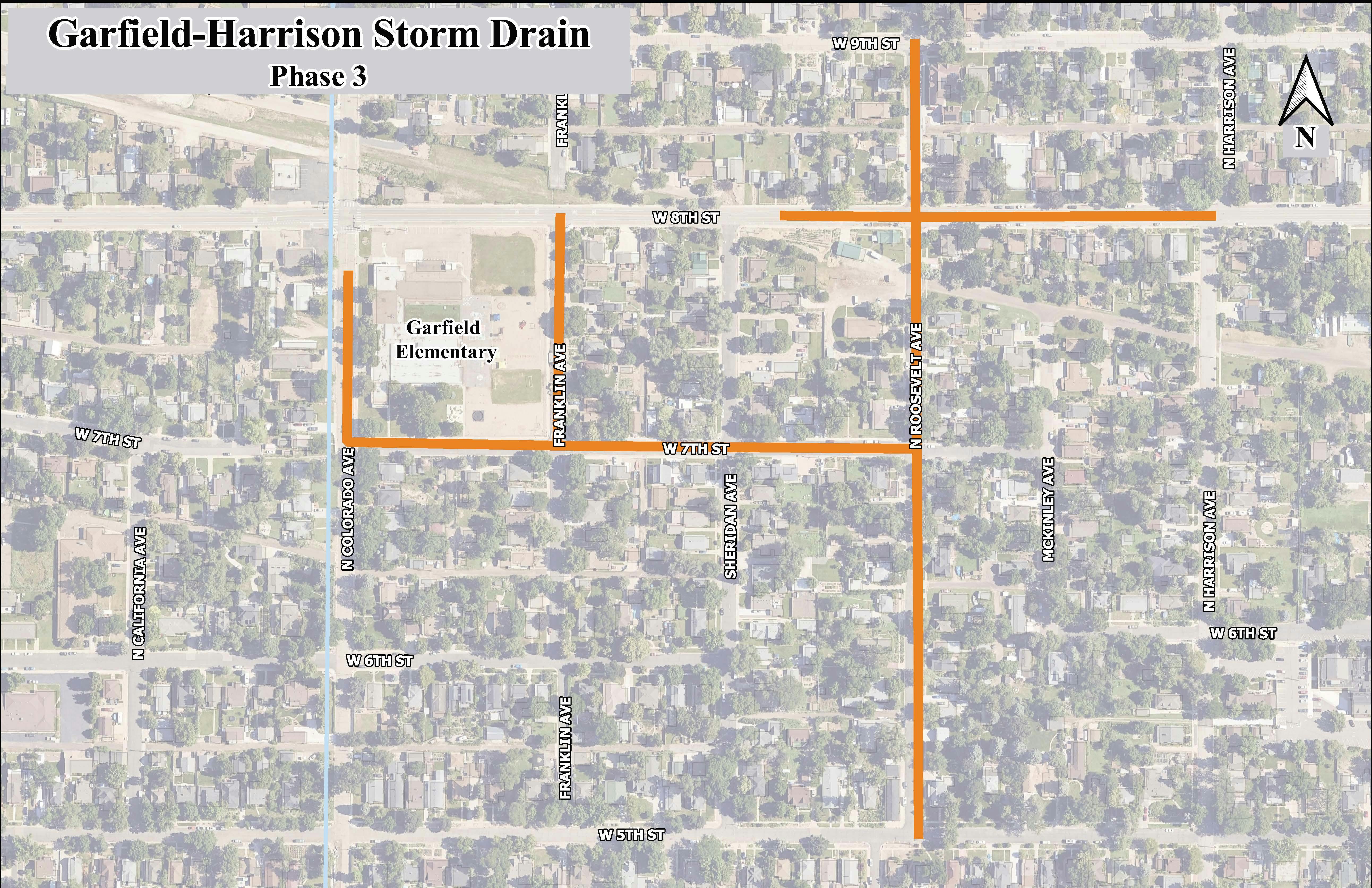

Work on Phase 3 is well underway with Zones 1-3 currently in construction. The project includes five work zones for Phase 3 beginning August 12, 2024, through winter 2025:
Zone 1 - Roosevelt Avenue between 5th and 8th Street: Roadway will be closed to install new stormwater and waterlines. Zone 1 is estimated to be completed by spring 2025.
Zone 2 - 8th Street between Sheridan Avenue and Harrison Avenue: The roadway will be closed to install new stormwater. Zone 2 is estimated to be completed spring 2025.
Zone 3 - 7th Street between Franklin Avenue and Roosevelt Avenue: The roadway will be closed to install new stormwater. Zone 1 is estimated to be completed spring 2025.
Zone 4 - Colorado Avenue between 7th Street and 8th Street and Franklin Avenue between 7th Street and 8th Street, 7th Street between Franklin and Colorado will undergo a full road closure to add to the continuation of installing the new stormwater. Zone 4 is estimated to be completed by late summer 2025.
Zone 5 - 8th Street between Duffield Avenue and Colorado Avenue: The roadway will be closed to install new stormwater. Zone 5 is estimated to be completed by spring 2026.
A large-diameter storm sewer pipe will be installed on N. Roosevelt Avenue to W. 9th Street and then a smaller-diameter lateral west on W. 7th Street to Colorado Avenue. Additionally, the project will include adding a new waterline on N. Roosevelt Avenue between W. 5th Street and W. 8th Street. Under the five work zones, road closures in blocked segments will be required to install the new water and stormwater pipelines. The road closures will follow the timeline of the work zones.
During construction, local access, deliveries, and services will always be maintained. Residents will experience construction noise and disruptions near their homes. Traffic control personnel will be onsite to direct residents during this work. Typical working hours will be Monday through Friday from approximately 7 a.m. to 5 p.m. Night and weekend work will be occasional and announced in advance.
Learn about the phasing of this project
How is this project funded?
Estimated total project cost: $18 million
The project is funded through the Stormwater and Water Enterprise Fund. Enterprise funds are dedicated funds supported by user fees in the monthly utility bill. Similar to a business, user fees fund the operation, maintenance, administration, and capital improvement projects required to provide the service.
Stay Informed
To stay informed about this project, subscribe to our email list in the "Stay Informed" section. For immediate questions or concerns, contact us at: garfieldharrisonstormdrain@gmail.com or 970-716-5155. Please allow us at least 24-48 hours to respond to you. Thank you!
The Garfield-Harrison Project is a large-scale master planned Stormwater project that began in January 2022. The City of Loveland has contracted with Connell Resources to build the Garfield Harrison Storm Drainage Improvements Project. The four separate phases are expected to occur over the next four years (approximately one phase per year.) The project addresses the multiple drainage problems caused by aging infrastructure in the west part of downtown Loveland. Partnering with the City’s Water and Wastewater divisions, Street Maintenance and Rehabilitation Program, and Stormwater Engineering, the project will include new waterlines, sanitary sewers, street resurfacing, and various concrete repairs that will improve ADA accessibility.
The four-year project is designed to improve the following:
Implementation of the City of Loveland Master Drainage Plan
Replacing and upgrading existing stormwater infrastructure to address existing drainage issues and meet current stormwater standards
Installing 18- to 60-inch diameter storm sewer pipes
Replacing existing waterlines and valves to address aging infrastructure
Replacing pavement including asphalt patching, milling, overlays, or full street reconstruction where project components are installed
Rehabilitating and replacing concrete, as well as adding necessary ADA improvements
Disconnecting stormwater from the Little Barnes Ditch during Phase 4
Providing stormwater quality treatment measures within the stormwater system
The four-phase project is expected to be completed in fall 2027.
Phase 3
Work on Phase 3 is well underway with Zones 1-3 currently in construction. The project includes five work zones for Phase 3 beginning August 12, 2024, through winter 2025:
Zone 1 - Roosevelt Avenue between 5th and 8th Street: Roadway will be closed to install new stormwater and waterlines. Zone 1 is estimated to be completed by spring 2025.
Zone 2 - 8th Street between Sheridan Avenue and Harrison Avenue: The roadway will be closed to install new stormwater. Zone 2 is estimated to be completed spring 2025.
Zone 3 - 7th Street between Franklin Avenue and Roosevelt Avenue: The roadway will be closed to install new stormwater. Zone 1 is estimated to be completed spring 2025.
Zone 4 - Colorado Avenue between 7th Street and 8th Street and Franklin Avenue between 7th Street and 8th Street, 7th Street between Franklin and Colorado will undergo a full road closure to add to the continuation of installing the new stormwater. Zone 4 is estimated to be completed by late summer 2025.
Zone 5 - 8th Street between Duffield Avenue and Colorado Avenue: The roadway will be closed to install new stormwater. Zone 5 is estimated to be completed by spring 2026.
A large-diameter storm sewer pipe will be installed on N. Roosevelt Avenue to W. 9th Street and then a smaller-diameter lateral west on W. 7th Street to Colorado Avenue. Additionally, the project will include adding a new waterline on N. Roosevelt Avenue between W. 5th Street and W. 8th Street. Under the five work zones, road closures in blocked segments will be required to install the new water and stormwater pipelines. The road closures will follow the timeline of the work zones.
During construction, local access, deliveries, and services will always be maintained. Residents will experience construction noise and disruptions near their homes. Traffic control personnel will be onsite to direct residents during this work. Typical working hours will be Monday through Friday from approximately 7 a.m. to 5 p.m. Night and weekend work will be occasional and announced in advance.
Learn about the phasing of this project
How is this project funded?
Estimated total project cost: $18 million
The project is funded through the Stormwater and Water Enterprise Fund. Enterprise funds are dedicated funds supported by user fees in the monthly utility bill. Similar to a business, user fees fund the operation, maintenance, administration, and capital improvement projects required to provide the service.
Stay Informed
To stay informed about this project, subscribe to our email list in the "Stay Informed" section. For immediate questions or concerns, contact us at: garfieldharrisonstormdrain@gmail.com or 970-716-5155. Please allow us at least 24-48 hours to respond to you. Thank you!
Share Project weekly update 07/15/2024 - 07/19/2024 on FacebookShare Project weekly update 07/15/2024 - 07/19/2024 on TwitterShare Project weekly update 07/15/2024 - 07/19/2024 on LinkedinEmail Project weekly update 07/15/2024 - 07/19/2024 link
Hello Stakeholders!
Here are the project updates for this week (7/15 -7/19).

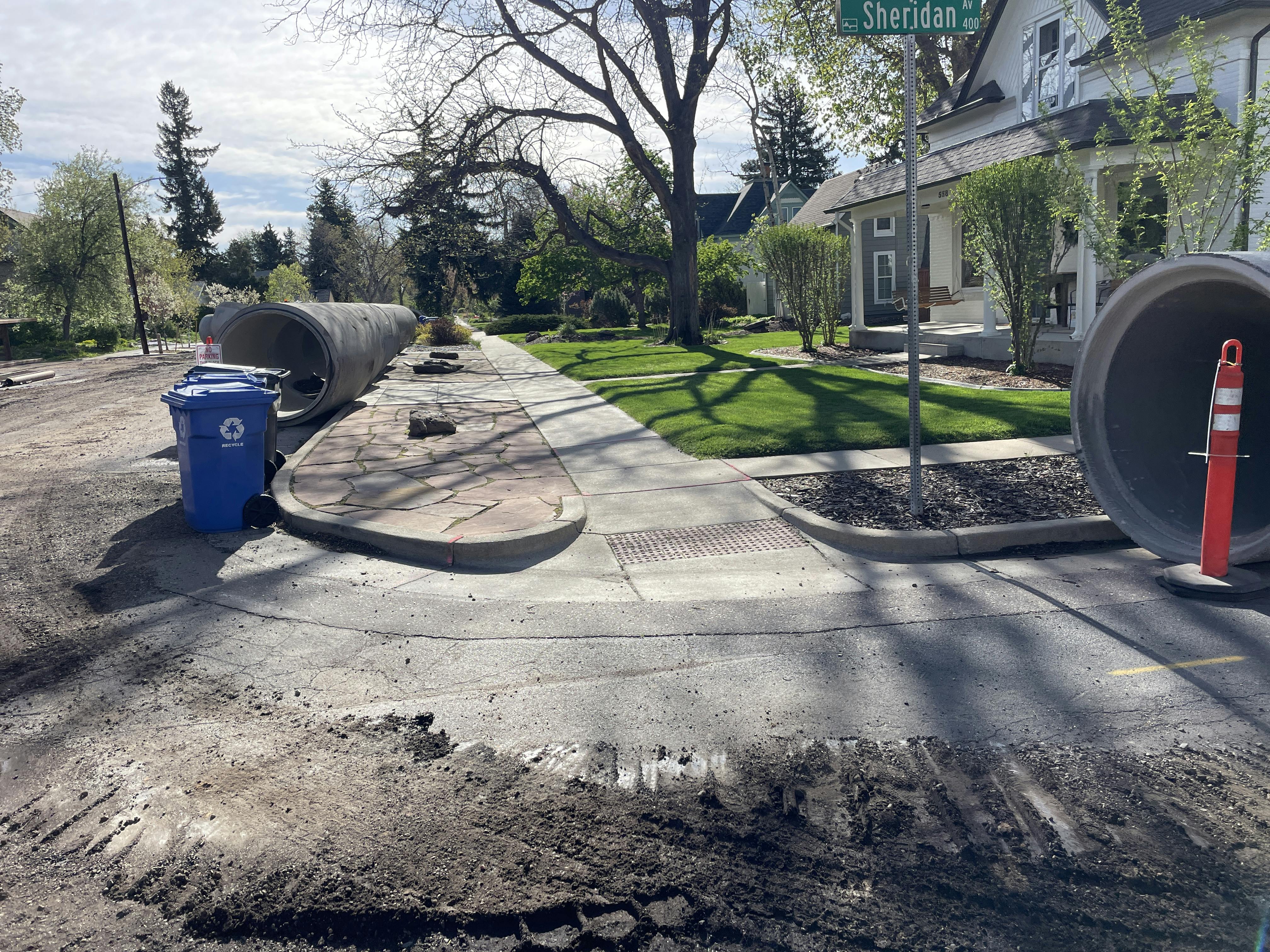

The large 54” storm sewer installation continues on 5th Street and is currently at the intersection of Roosevelt Avenue and 5th Street.
Following the stormsewer, the waterline installation will begin. Concrete repairs and installations will continue along 5th Street.
Milling on Roosevelt Avenue is complete and stockpiling of pipe materials will be ongoing.
Weather permitting, work activities are Monday-Friday, 7:00 a.m. – 5:00 p.m. Please contact us with any questions at garfieldharrisonstormdrain@gmail.com or 970-716-5155.
Thank you for your continued patience and support.
Share Project weekly update 07/08/2024 - 07/12/2024 on FacebookShare Project weekly update 07/08/2024 - 07/12/2024 on TwitterShare Project weekly update 07/08/2024 - 07/12/2024 on LinkedinEmail Project weekly update 07/08/2024 - 07/12/2024 link
Hello Stakeholders!
Here are the project updates for this week (7/8 -7/12).
The team will take off July 4-7 and return to work on Monday, July 8.
Sheridan west of 5th Street will be off temporary water and paving preparations will continue. A bottom mat is planned for Thursday, August 1.
A large 54-inch storm sewer will continue to be installed going east on 5th Street to Roosevelt Avenue. Waterline installation will follow.
Milling and storage of pipe along 5th Street to 7th Street on Roosevelt Avenue is planned for Monday.
Weather permitting, work activities are Monday-Friday, 7:00 a.m. – 5:00 p.m. Please contact us if you have any questions at garfieldharrisonstormdrain@gmail.com or 970-716-5155.
Thank you for your continued patience and support.
Share Project weekly update 07/01/2024 - 07/03/2024 on FacebookShare Project weekly update 07/01/2024 - 07/03/2024 on TwitterShare Project weekly update 07/01/2024 - 07/03/2024 on LinkedinEmail Project weekly update 07/01/2024 - 07/03/2024 link
Hello Stakeholders!
Here are the project updates for this week (7/1 -7/3).
Waterline will continue to be installed on Sheridan Avenue and should conclude mid-week. A large 54-inch storm sewer will follow, going east from Sheridan Avenue to Roosevelt Avenue.
Potholing activities for utilities will be occurring concurrently, and vac trucks will assist with meter box replacements during the waterline installation.
Street preparation for paving and concrete replacements will be ongoing on both Sheridan Avenue and W. 5th Street in preparation for paving activities starting in July.
The team will take off July 4 - 7 and return to work on the 8th Street.
Weather permitting, work activities are Monday-Friday, 7:00 a.m. – 5:00 p.m. Please contact us if you have any questions at garfieldharrisonstormdrain@gmail.com or 970-716-5155.
Thank you for your continued patience and support.
Share Project weekly update 06/24/2024 - 06/28/2024 on FacebookShare Project weekly update 06/24/2024 - 06/28/2024 on TwitterShare Project weekly update 06/24/2024 - 06/28/2024 on LinkedinEmail Project weekly update 06/24/2024 - 06/28/2024 link
Hello Stakeholders!
Here are the project updates starting this week, 6/24:
Waterline will continue to be installed on Sheridan Ave. and should conclude mid-week. A large 54-inch storm sewer will follow going east from Sheridan Avenue to Roosevelt Avenue.
Potholing activities for utilities will be occurring concurrently and vac trucks will be assisting with meter box replacements as the waterline installation occurs.
Street preparation for paving and concrete replacements will be ongoing on both Sheridan Avenue and W. 5th Street in preparation for paving activities starting in July.
Weather permitting, work activities are Monday-Friday, 7:00 a.m. – 5:00 p.m. Please contact us if you have any questions at garfieldharrisonstormdrain@gmail.com or 970-716-5155.
Thank you for your continued patience and support.
Share Project weekly update 06/17/2024 - 06/21/2024 on FacebookShare Project weekly update 06/17/2024 - 06/21/2024 on TwitterShare Project weekly update 06/17/2024 - 06/21/2024 on LinkedinEmail Project weekly update 06/17/2024 - 06/21/2024 link
Hello Stakeholders!
Here are the project updates starting this week, 6/17:
Street paving preparation work will occur next week between 4th & 5th Streets on Sheridan Avenue. Bottom mat paving is planned for the following week.
Concrete crews will continue working on handicap ramps and curb and gutter.
Storm sewer crews on 5th Street, west of Sheridan Avenue will wrap up their work and new 8-inch waterline will be installed.
Weather permitting, work activities are Monday-Friday, 7:00 a.m. – 5:00 p.m. Please contact us if you have any questions at garfieldharrisonstormdrain@gmail.com or 970-716-5155.
Thank you for your continued patience and support.
Share Project weekly update 06/10/2024 - 06/14/2024 on FacebookShare Project weekly update 06/10/2024 - 06/14/2024 on TwitterShare Project weekly update 06/10/2024 - 06/14/2024 on LinkedinEmail Project weekly update 06/10/2024 - 06/14/2024 link
Hello Stakeholders!
Here are the project updates starting this week, 6/10:
This week the new 8-inch waterline will be tied in at Franklin Avenue & 5th Street and begin installation moving east.
Concrete crews will be installing the curb and gutter.
Inlets will also be constructed at Franklin Avenue & 5th Street.
Weather permitting, work activities are Monday-Friday, 7:00 a.m. – 5:00 p.m. Please contact us if you have any questions at garfieldharrisonstormdrain@gmail.com or 970-716-5155.
Thank you for your continued patience and support.
Share Project weekly update 06/03/2024 - 06/07/2024 on FacebookShare Project weekly update 06/03/2024 - 06/07/2024 on TwitterShare Project weekly update 06/03/2024 - 06/07/2024 on LinkedinEmail Project weekly update 06/03/2024 - 06/07/2024 link
Hello Stakeholders!
Here are the project updates starting this week, 6/03:
Storm sewer installation at Franklin Avenue & 5th Street will continue through the week.
The waterline will begin following the storm sewer the following week.
Concrete repairs and ADA-compliant handicap ramps will also be built concurrently on Sheridan Avenue in preparation for paving at the end of June.
Weather permitting, work activities are Monday-Friday, 7:00 a.m. – 5:00 p.m. Please contact us if you have any questions at garfieldharrisonstormdrain@gmail.com or 970-716-5155.
Thank you for your continued patience and support.
Share Project weekly update 05/27/2024 - 05/31/2024 on FacebookShare Project weekly update 05/27/2024 - 05/31/2024 on TwitterShare Project weekly update 05/27/2024 - 05/31/2024 on LinkedinEmail Project weekly update 05/27/2024 - 05/31/2024 link
Hello Stakeholders!
Here are the project updates starting this week, 5/27
No work was performed on Monday, 5/27, due to the observance of Memorial Day.
The stormsewer will continue to be installed between Franklin and Sheridan. Upon completion, the stormsewer will begin from Sheridan Avenue to Roosevelt Avenue
Waterline installation will begin the first week of June following the stormsewer.
Weather permitting, work activities are Monday-Friday, 7:00 a.m. – 5:00 p.m. Please contact us if you have any questions at garfieldharrisonstormdrain@gmail.com or 970-716-5155.
Thank you for your continued patience and support.
Share Project weekly update 05/13/2024 - 05/17/2024 on FacebookShare Project weekly update 05/13/2024 - 05/17/2024 on TwitterShare Project weekly update 05/13/2024 - 05/17/2024 on LinkedinEmail Project weekly update 05/13/2024 - 05/17/2024 link
Hello Stakeholders!
Here are the project updates starting this week, 5/13
Next week, work will begin installing the 18-inch lateral to the west on 5th Street. This process will be much faster compared to working with the 54-inch pipe.
The waterline installation will follow the storm sewer installation.
Concrete repairs and ADA ramp installations will work up Sheridan Avenue from 4th Street to 5th Street.
Weather permitting, work activities are Monday-Friday, 7:00 a.m. – 5:00 p.m. Please contact us if you have any questions at garfieldharrisonstormdrain@gmail.com or 970-716-5155.
Thank you for your continued patience and support.
Share Project weekly update 05/06/2024 - 05/10/2024 on FacebookShare Project weekly update 05/06/2024 - 05/10/2024 on TwitterShare Project weekly update 05/06/2024 - 05/10/2024 on LinkedinEmail Project weekly update 05/06/2024 - 05/10/2024 link
Hello Stakeholders!
Here are the project updates starting this week, 5/6.
Work will continue installing the large 54-inch storm sewer on Sheridan Avenue.
Upon reaching 5th Street, a storm sewer lateral will be built west of the Franklin Avenue intersection.
A new waterline will follow the storm sewer.
Upon completing the lateral to Franklin Avenue, the large storm sewer trunkline will begin again at 5th Street and Sheridan Avenue and travel east to Roosevelt Avenue.
Weather permitting, work activities are Monday-Friday, 7:00 a.m. – 5:00 p.m. Please contact us if you have any questions at garfieldharrisonstormdrain@gmail.com or 970-716-5155.
Thank you for your continued patience and support.
Phase 2c will begin April 1, 2024, weather permitting. Phase 2c will include:
Street milling will begin March 25.
A large diameter stormsewer pipe will be installed up to 5th Street and then east to Roosevelt. Excavation for the pipe will be extensive and require a full road closure.
New waterline will be installed on 5th Street between California and Roosevelt Avenues.

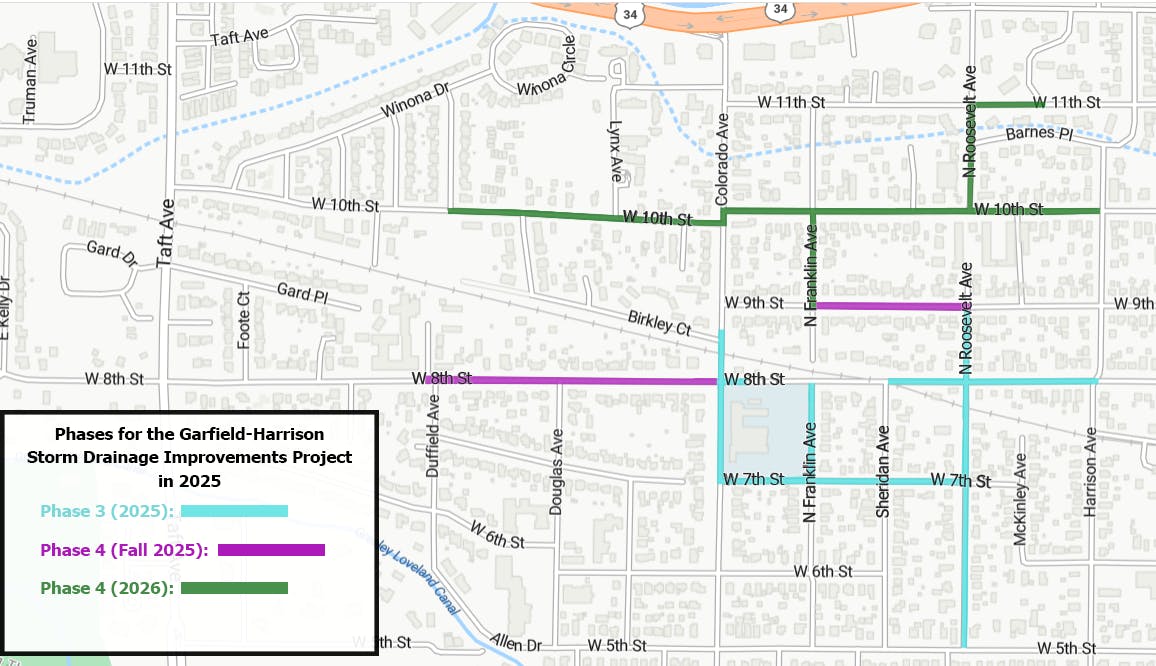

Phase 3
Garfield-Harrison Project is currently at this stage
August 12, 2024, through November 2026

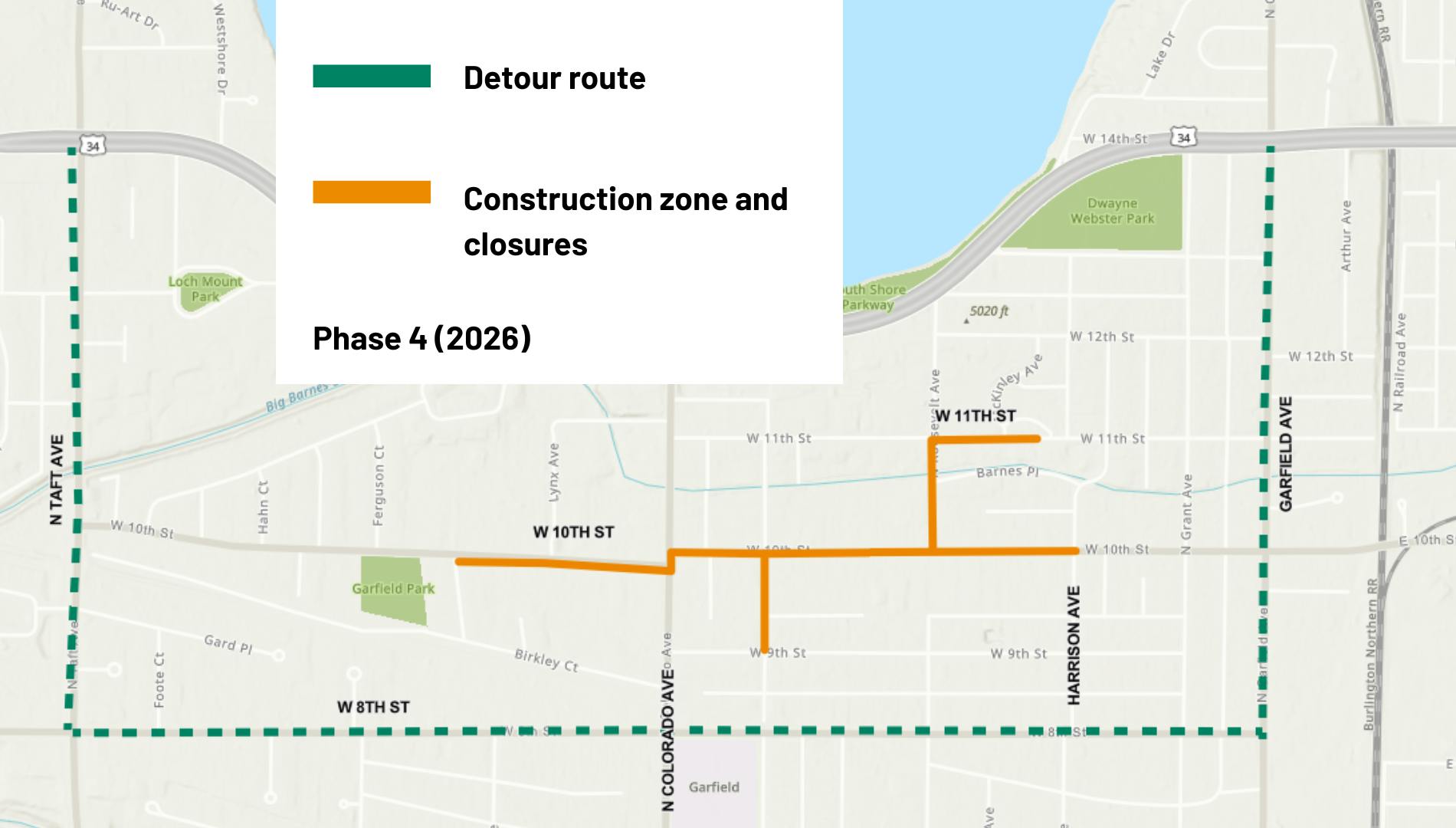

Phase 4
this is an upcoming stage for Garfield-Harrison Project
Fall 2026
Videos
Click here to play video
Find out more about the Garfield/Harrison project with this informative video.
Click here to play video
Drone footage of W. 1st Street taken November 2021 prior to Phase 1 construction. Ongoing videos will be created to show construction progress.
Drone footage of W. 1st Street taken November 2021 prior to Phase 1 construction. Ongoing videos will be created to show construction progress.
